Item Planning Parameters

Master the Item Card Planning tab — reordering policies, safety stock, order modifiers, and how the planning engine calculates supply.

40 minIntermediate

Learning Objectives

  • Configure Fixed Reorder Qty, Maximum Qty, Order, and Lot-for-Lot policies
  • Set safety stock, lead time, and order modifiers
  • Run the planning worksheet and interpret supply suggestions

Overview

The Planning tab on the Item Card defines how Business Central decides when and how much to replenish.

  • Replenishment = Where supply comes from (Purchase, Production, etc.)
  • Planning = How the system calculates supply

Think of it as: "When do I need more, and how much should I get?"

This setup drives the Requisition Worksheet, Planning Worksheet, and automatic supply suggestions.

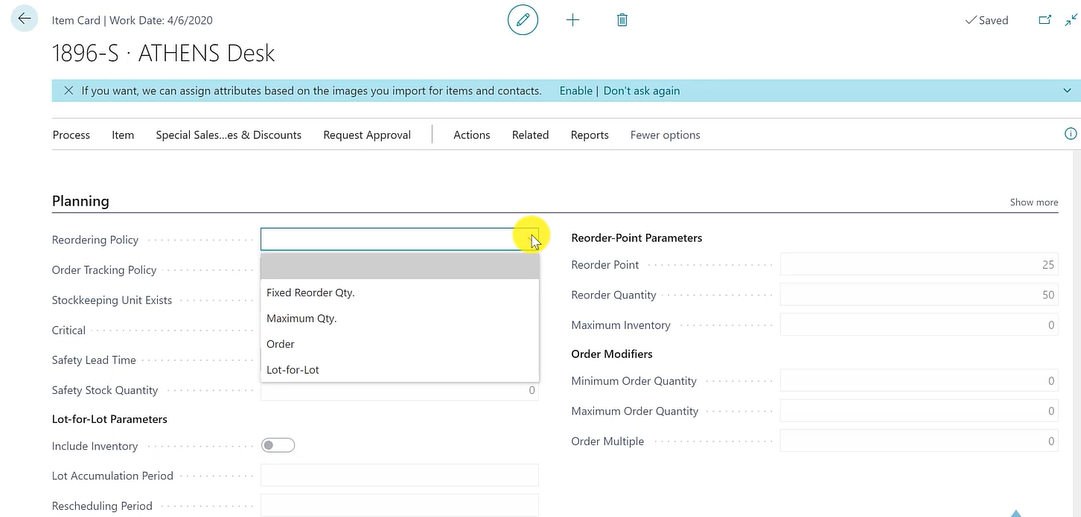

Planning Tab

Reordering Policy — The Most Important Field

The Reordering Policy defines the logic used by the planning engine.

Fixed Reorder Quantity

When inventory drops below the Reorder Point, the system suggests a fixed quantity.

Example: Reorder Point = 10, Reorder Quantity = 50, Current Stock = 9 → Suggest: Order 50

Use for: Simple replenishment, stable consumption. Limitation: Can lead to overstock.

Maximum Quantity

When inventory drops below the Reorder Point, replenish up to a maximum level.

Example: Reorder Point = 20, Maximum = 100, Current Stock = 30 → Suggest: Order 70

Use for: Retail and warehouse scenarios maintaining optimal stock levels.

Order (Demand-Driven)

Each demand (Sales Order, etc.) creates its own supply.

Example: Sales Order = 7 units → Suggest: Order/Produce 7

Use for: Custom items, Make-to-Order scenarios. Limitation: Many small orders.

Lot-for-Lot

Groups demand over a time period and suggests supply matching total demand.

Example: Day 1 demand = 3, Day 2 demand = 4 → Suggest: Order 7 (single order)

Use for: Manufacturing, optimized planning.

Order vs Lot-for-Lot

PolicyBehavior
OrderOne supply per demand
Lot-for-LotGroups multiple demands

Order Modifiers

ParameterPurpose
Minimum Order QuantityEnsures orders are not too small
Maximum Order QuantityCaps order size
Order MultipleForces quantities to multiples (e.g., 10, 20, 30…)

Safety Parameters

  • Safety Stock Quantity — Buffer against demand variability and delays
  • Safety Lead Time — Extra time added to replenishment lead time

Planning in Practice

Scenario — Sales Order for 7 units:

PolicySuggestion
Order7 units
Fixed Reorder QtyFixed amount (e.g., 50)
Lot-for-Lot7 (or grouped demand)
Maximum QtyUp to max level

Pro Tip

Test this flow: Create Sales Order → Run Planning Worksheet → Review Suggestions → Execute Orders. This is how planning works in real projects and MB-800 interviews.

Relationship with Replenishment

SetupRole
ReplenishmentDefines source (Purchase / Production / etc.)
PlanningDefines quantity and timing

Example: Replenishment = Production + Planning = Lot-for-Lot → System creates Production Orders based on grouped demand.

Best Practices

  • Use Order / Lot-for-Lot for demand-driven environments (projects, custom production)
  • Use Fixed / Maximum for stable consumption (retail, stock items)
